-
Environmental Site Assessment
Wetland delineator walks property and places boundary markers — the essential first step before any Florida construction permitting.
-
Environmental Assessment Report Received
Formal wetland report delivered with soil analysis, plant species identification, and wetland classification.
-
Boundary Survey Received
Licensed surveyors deliver boundary survey establishing official property perimeter — required for all permits.
-
Land Purchase Closed
Property purchase completed after environmental and boundary survey due diligence confirmed buildable area.
-
Combined Survey Package Received
Comprehensive survey package delivered — boundary, topography, tree locations, and wetland markers in one document.
-
Conservation Area Determination Filed
Conservation Area Determination filed with Orange County EPD to establish official wetland boundaries and buffer requirements.
-
Joint County & Consultant Site Visit
Orange County EPD and environmental consultant jointly walk property to verify and agree on official wetland delineation.
-
Architectural Design Contract Signed
Architectural contract signed with DBSS for custom 4,878 sq ft CBS home design incorporating wetland buffer setbacks.
-
First Architectural Draft Received
First architectural drawings received from DBSS — design incorporates wetland buffers and optimal positioning within buildable envelope.
-
Wetland Delineation Agreement Received
Orange County issues formal Delineation Agreement letter confirming official wetland boundaries — required before NGP application.
-
Signed Delineation Agreement Returned
Signed and returned Orange County Delineation Agreement — creating legal foundation for all subsequent environmental permits.
-
Wetland Determination Certificate Issued
Official Wetland Determination Certificate issued by Orange County EPD — valid 5 years, required for all NGP applications.
-
NGP Consultant Selected
NGP consultant engaged — specialist knowledge of Orange County wetland permitting process is essential and worth every dollar.
-
Ranger Drainage District Vacation Filed
Easement vacation application filed with Ranger Drainage District to gain flexibility for house placement and driveway design.
-
Ranger Drainage District Vacation Approved
Ranger Drainage District approves easement vacation — but Orange County approval still required for full legal release.
-
Orange County Easement Vacation Meeting
Met with Orange County to initiate easement vacation — utility no-objection letters, neighbor notification, and public notice signs all required.
-
Orange County Vacation Petition Filed
Easement vacation petition formally filed with Orange County — budget 2–6 months and multiple department reviews.
-
Final Site Plan Approved
Final site plan approved after multiple revisions — wetland buffers, stormwater, setbacks, and driveway placement all confirmed.
-
Noticed General Permit Application Filed
NGP application filed with Orange County EPD — streamlined wetland permit for projects with minimal but unavoidable buffer encroachment.
-
Noticed General Permit Issued
NGP approved by Orange County — authorizes construction within buffer zones under specific monitoring and reporting conditions.
-
Ranger Drainage District Permit Applied
Driveway and drainage permit application filed with Ranger Drainage District — required before Orange County building permit.
-
Ranger Drainage District Permit Issued
Ranger Drainage District permit issued specifying culvert size, driveway specs, and site drainage requirements.
-
Orange County Vacation Recorded
Orange County officially records easement vacation — modified boundaries now legally in effect after an 8-month process.
-
Building Permit Application Submitted
Building permit application submitted through Orange County Fast Track with full architectural, structural, and environmental documentation.
-
Building Permit Issued
Building permit issued by Orange County — master permit authorizes vertical construction and all trade sub-permits.
-
Wetland Buffer Stakes Installed
Surveyor stakes wetland buffer lines before clearing — highly visible markers prevent accidental buffer violations and fines.
-
Driveway Culvert Pipes Installed
Culvert pipes installed under driveway — circular driveway designs require two culvert crossings, doubling the cost.
-

Land Clearing Commenced
Land clearing begins — building envelope cleared to bare dirt with silt fencing installed at all wetland buffer boundaries.
-
Corner Stakes Set by Surveyor
Surveyor stakes exact house corners post-clearing — reference points that guide all foundation work and construction inspections.
-
Land Clearing Completed
Land clearing completed — building envelope cleared, graded, and ready for foundation work with all wetland setbacks maintained.
-
Irrigation Well Drilled
Separate irrigation well installed same day as domestic well — reduces domestic demand and saves on drilling mobilization costs.
-
Domestic Water Well Drilled
125-foot domestic water well drilled by WaterWorks — SJRWMD permit required in advance for all well installations.
-
Silt Fence Reinstalled
Silt fence failed RDD inspection and required full reinstallation — hire professionals, inspectors have very specific installation requirements.
-
Foundation Footer Preparation
Footer trenches excavated and rebar installed — critical: ground rod must be bonded to rebar BEFORE pour for electrical inspection.
-
Footer Inspection — Corrections Required
First footer inspection found minor deficiencies — corrections made same day, reinspection scheduled next morning.
-
Electrical Bonding Inspection Passed
Electrical bonding inspection passed — 20-foot ground rod bonded to footer rebar creates the structure’s complete grounding system.
-
Footer Reinspection Passed
Footer reinspection passed — rebar, forms, and dimensions approved, concrete pour now authorized.
-
Foundation Footers Poured
Foundation footers poured at dawn with two concrete trucks — early morning scheduling critical in Florida’s heat.
-
Stem Wall Block Construction
4-course CMU stem wall construction begins — raises house above grade for flood protection and termite prevention in Florida.
-
Stem Wall Inspection Passed
Stem wall inspection passed — block placement, mortar joints, rebar, and bond beams all approved by Orange County.
-
Stem Wall MEP Rough-In
Under-slab MEP rough-in complete — waste lines, supply runs, and conduit sleeves must be installed before stem wall cores are filled.
-
Stem Wall Cores Filled
Stem wall cores filled with pumped concrete grout — encases vertical rebar and completes the reinforced foundation wall.
-

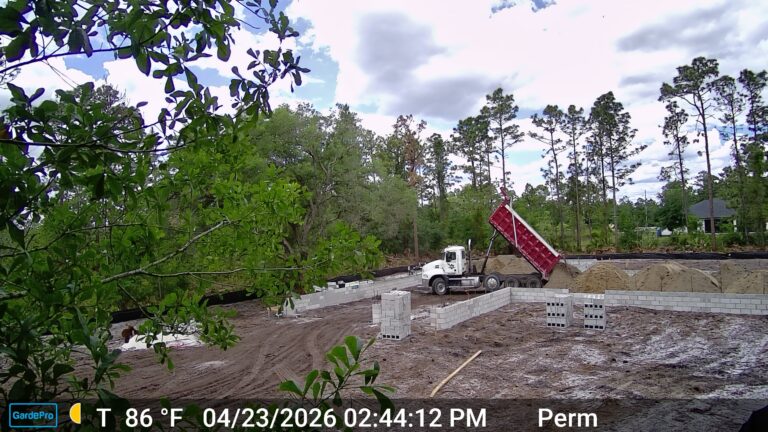

Fill Dirt Delivered — 25 Truckloads
25 truckloads of fill dirt delivered — must be compacted in lifts with geotechnical testing before slab pour.
